Overview

This Quick Reference Guide (QRG) is intended for Buyers who need to create a sourcing project in the eMaryland Marketplace Advantage (eMMA). It shows you how to create a solicitation from creation of the sourcing project in eMMA, to sending out your published solicitation.

This QRG is broken down into 9 sections:

TABLE OF CONTENTS

NOTE: For best results, use the Google Chrome browser to access eMMA.

If you need help at any time, please reach out to the eMMA helpdesk at emma.helpdesk@maryland.gov.

Step-by-Step Instructions

Create a Sourcing Project

NOTE: This QRG uses diagrams with specific callouts to show required and optional fields in forms. A yellow callout with a red border null indicates a required field, while yellow callouts with a black border null indicate optional fields. Letters within the callouts correspond to the explanations below the diagram.A red asterisk (*) indicates a required field.

  1. Access eMMA at https://emma.maryland.gov and log in with your credentials.

    NOTE: Depending on your agency, you may only need to click the State SSO Login (Secure Auth) button or the MDOT SSO Login (MSAzure) button and log in with your credentials.

  2. Click the Sourcing tab at the top of the screen and select Create Project from the drop-down menu that opens.

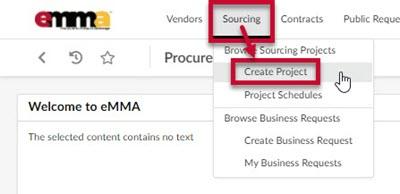

    The Sourcing tab and the Create Project option in the drop-down menu.

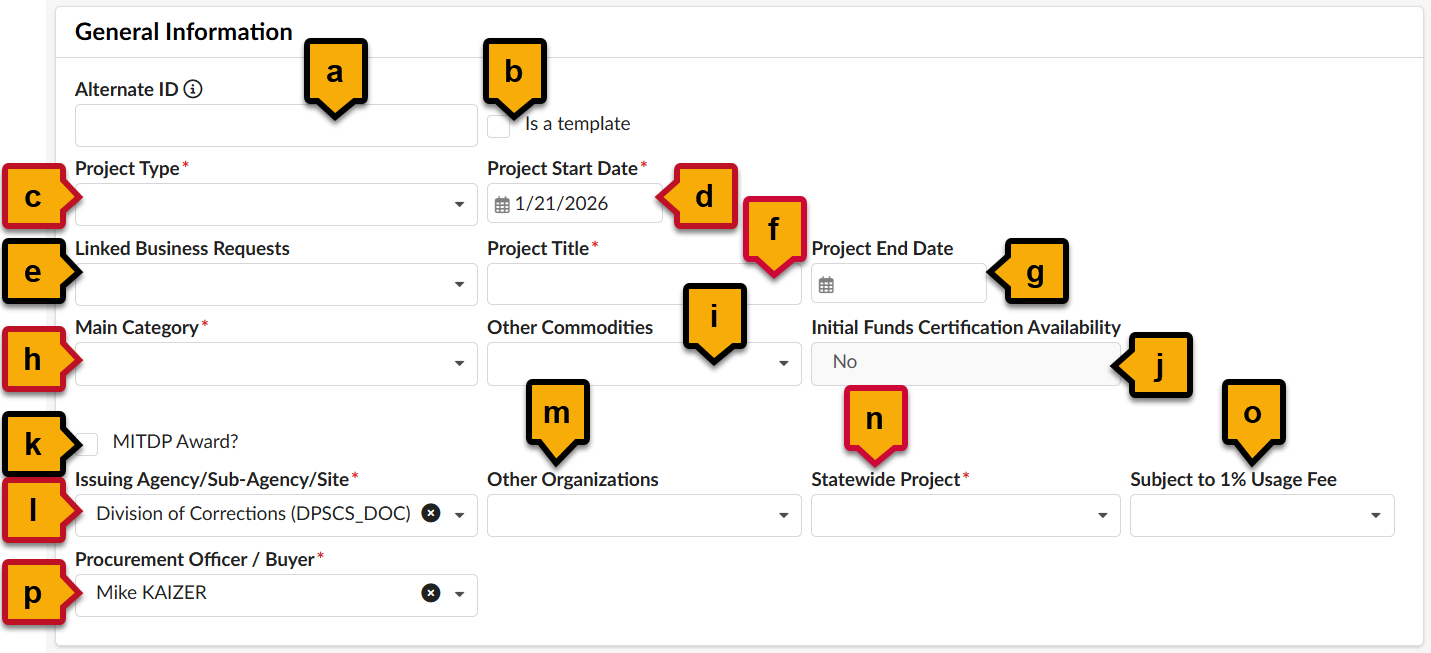

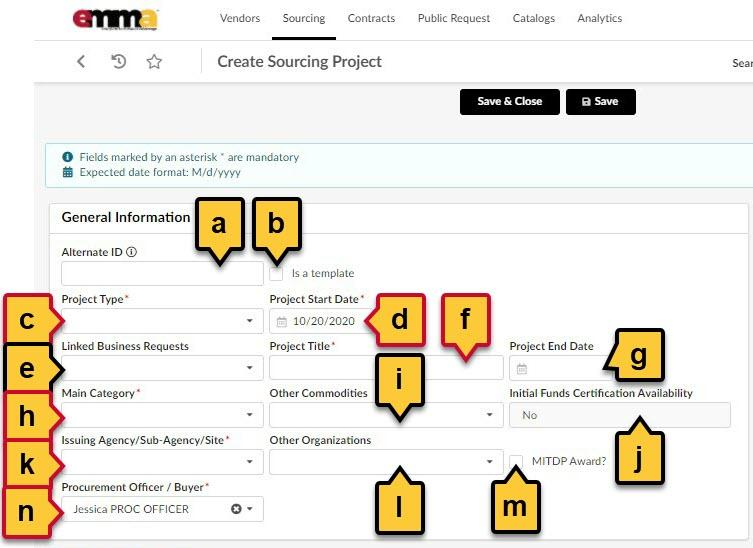

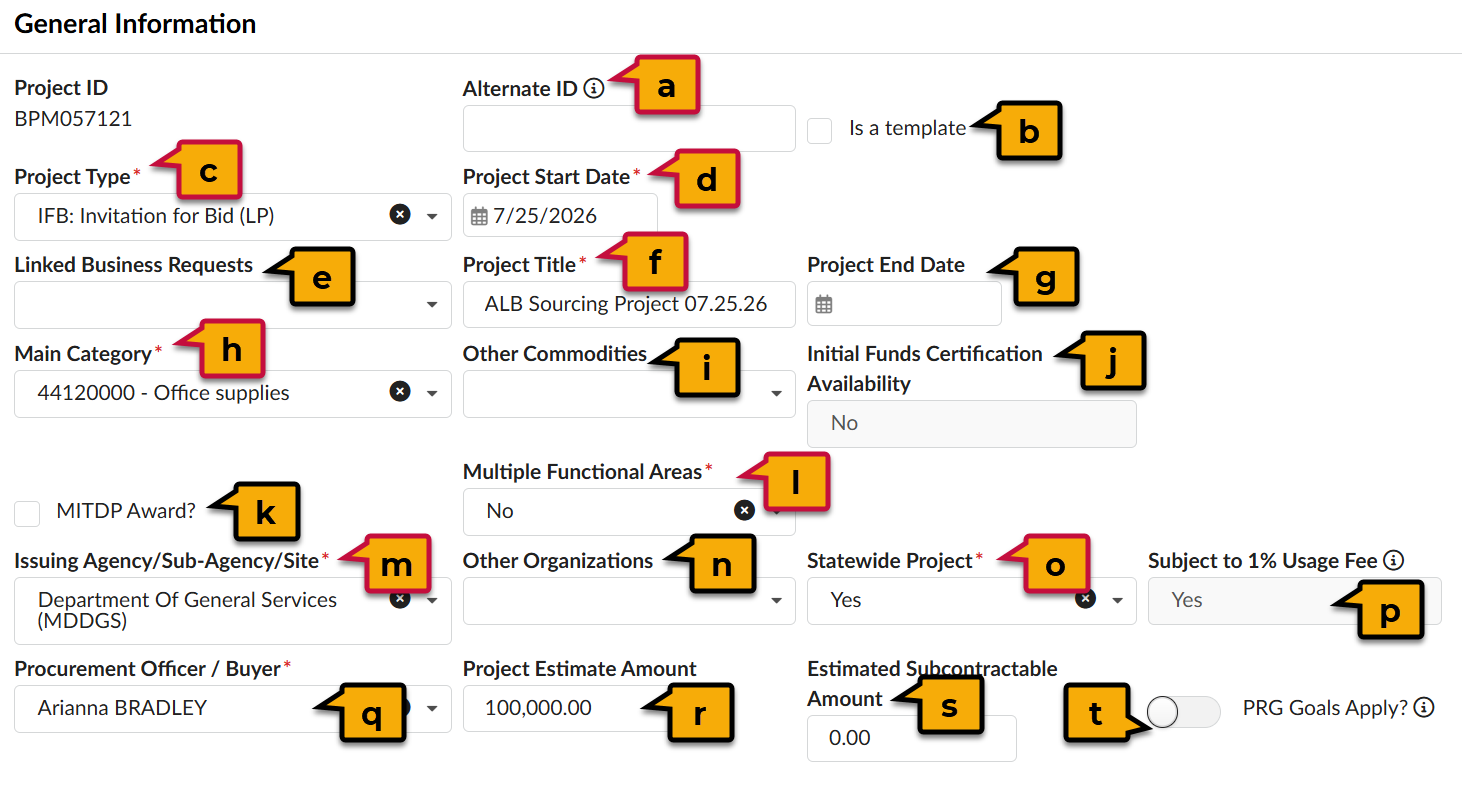

  1. Enter information in the fields of the General Information section. A red asterisk (*) indicates a required field. The diagram below shows required fields described in more detail.

    NOTE: Additional fields may display depending on your selections.
    1. Alternate ID: This field is an additional identifier. If you have a Financial Management Information System (FMIS) number, external project number or an internal contract number, enter it here. If not, then skip this field.
    2. Is a template (checkbox): Click this checkbox if you plan to make this sourcing project a template for other projects.
    3. Project Type (*):Click this field to open the drop-down menu and select the appropriate project type. Options include:
      • IFB: Invitation for Bid (LP): Select if the contract is to be awarded to the responsible bidder submitting a responsive bid with the most favorable bid price.
      • RFP: Double Envelope Proposal (LP): Select if the State plans to award the contract to the best solution in light of both the technical and financial proposals submitted by offerors.
      • RFP: Triple Envelope proposal (LP): Select if the State plans to award the contract to the best solution in light of both the technical and financial proposals submitted by offerors AND offerors must meet certain minimum requirements for consideration.
      • Small Procurement (e.g., Cat 1): Select if the procurement should follow the State's guidelines for small procurements. For more information, please refer to the Maryland Procurement Manual, Section 3.4.1 Small Procurement (SP) Categories (COMAR 21.05.07.04).
      • Small Procurement (e.g., Cat 2 & 3): Select if the procurement should follow the State's guidelines for small procurements. For more information, please refer to the Maryland Procurement Manual, Section 3.4.1 Small Procurement (SP) Categories (COMAR 21.05.07.04).
      • Public Notice: Select if the procurement will only be posted on eMMA and you do not intend to make an award directly within eMMA.
      • Emergency: Select if the procurement is an eligible Emergency Procurement as defined in Section 3.4.9 Emergency and Expedited Procurements of the Maryland Procurement Manual.
      • Secondary Competition: Select only if the procurement is in reference to an existing Master Contract With Secondary Competition.
        • NOTE: If you select the Secondary Competition Project Type, the Linked Business Requests field becomes mandatory. An additional mandatory Parent Sourcing Project field will also appear at the bottom of the General Information section where you will be required to enter the BPM number for your master sourcing project and select it from the drop-down menu when it appears.
          • NOTE: If you cannot find the master sourcing project, click the See All option. Remove the checkmark filter and click Search. Please reach out to helpdesk at emma.helpdesk@maryland.gov if you still cannot find the sourcing project.
    4. Project Start Date (*): Click this field to select a date on which to start the project.  If no date is selected, eMMA will default to the date you are creating the sourcing project as the Project Start Date.
    5. Linked Business Requests: Click this field to search for a Business Request if you need to link one to your new sourcing process.

      NOTE: Clicking See All opens a window in which all Business Requests are listed. Search for a term in the Keywords field and click the Search button to return relevant results. Select a business request from this list. The business request populates in the field.

    6. Project Title (*): Enter a title for your sourcing project in this field.
    7. Project End Date: Click this field if you know the date your project will end.
    8. Main Category (*): Click this field to open the drop-down menu and select one main category for your project or click See All at the bottom of the menu.

      NOTE: Clicking See All opens a window in which all categories are listed. Search for a term in the Keywords field and click the Search button to return relevant results. Use the plus A plus sign in a white box. and minus A minus sign in a little black box. icons to the left of the category groups to expand and collapse them. Select a category from this list. The category populates in the field.
    9. Other Commodities: Click this field to open the drop-down menu and select one or more additional categories for your project or click See All at the bottom of the menu. Selecting more commodities means you will get a broader scope of responses from vendors who can meet your project’s needs.

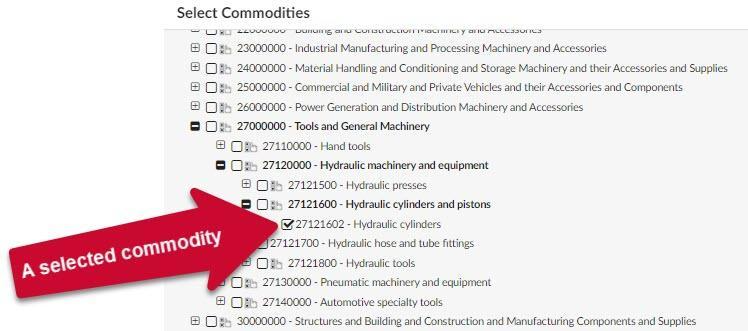

      NOTE: Clicking See All opens a window in which all commodities are listed. Search for a term in the Keywords field and click the Search button to return relevant results. Use the plus A plus sign in a white box. and minus A minus sign in a little black box. icons to the left of the commodity groups to expand and collapse them. It is imperative that you select as many and as detailed commodities as applies to your project. This ensures vendors from a wide range of commodities can find and bid on your solicitation. Select one or more commodity(ies) from this list and close the window. The commodity(ies) populates in the field.
    10. Initial Funds Certification Availability: This field is system generated. No further action required here.
    11. MITDP Award? (checkbox): Click this checkbox only if you have a Major IT Development Project Award.
    12. Multiple Functional Areas*: Indicates that goods or services will be separated by multiple functional areas. May indicate that there are multiple PRG requests associated with the sourcing project.
    13. Issuing Agency/Sub-Agency/Site (*): Click this field to open the drop-down menu and select appropriate Issuing Agency/Sub-Agency/Site for this project or click the See All option at the bottom of the menu.

      NOTE: Clicking See All opens a window in which all Agencies are listed. Search for a term in the Keywords field and click the Search button to return relevant results. Use the plus A plus sign in a white box. and minus A minus sign in a little black box. icons to the left of the agency groups to expand and collapse them. Select an agency from this list. The selected agency populates in the field.
    14. Other Organizations: Click this field to open the drop-down menu and select one or more additional organizations related to your project or click the See All option at the bottom of the menu.

      NOTE: Clicking See All opens a window in which all organizations in your agency are listed. Search for a term in the Keywords field and click the Search button to return relevant results. Use the plus A plus sign in a white box. and minus A minus sign in a little black box. icons to the left of the organizational groups to expand and collapse them. Select one or more organization(s) from this list and close the window. The organization(s) auto-populates in the field.
    15. Statewide Project (*): Indicate whether or not this solicitation will be for a Statewide procurement by selecting Yes or No from the drop-down menu. IMPORTANT: This field is only editable by DGS OSP users.
    16. Subject to 1% Usage Fee: This field will auto-populate as "Yes" if the Issuing Agency/Sub-Agency/Site is DGS or one of its subdivisions. For other agencies, the field sets to "No." If set to "Yes", the Electronic Transaction Fee Acknowledgement and Remittance Requirements will automatically be added to the Attachments sub-tab on the Prepare Solicitation tab.
    17. Procurement Officer/Buyer (*): This field auto-populates with your information. If this information is incorrect or needs to be changed, click this field to open the drop-down menu and select an option from the list. Click See All at the bottom of the menu to search through a list of all Procurement Officers/Buyers.

      NOTE: Clicking See All opens a window in which all Procurement Officers are listed. Search for a term in the Keywords field and click the Search button to return relevant results. Select a name from this list and close the window. The selected Procurement Officer/Buyer auto-populates in the field.
    18. Project Estimate Amount: Total estimated budget for the project.
    19. Estimated Subcontractable Amount: Total amount of the project that can be allocated to subcontractors.
    20. PRG Goals Apply: Do PRG goals apply to this project? If the project is linked to an intake request, this field will automatically populate based on the value of the request.

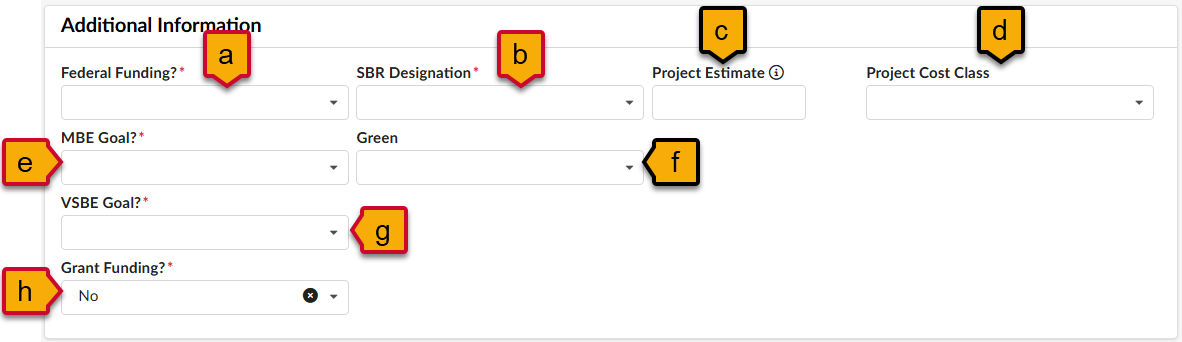

  2. Enter information in the Additional Information section. A red asterisk (*) indicates a required field. The diagram below shows required fields described in more detail below.

    NOTE: Additional fields may display depending on your selections.

    1. Federal Funding? (*): Does your project have federal funding? Click this field and select Yes or No.
        1. If you select Yes, two more fields display.
          1. DBE Goal?: Does your project have a DBE goal? Click this field and select Yes or No.
            1. If you selected Yes, a new field displays.

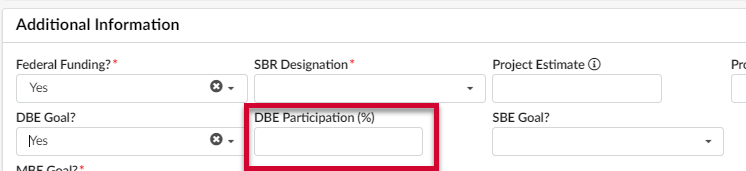

              1. DBE Participation (%): Enter the percentage of DBE participation this project will have.
                Graphical user interface, application
Description automatically generated
          2. SBE Goal?: Does your project have an SBE goal? Click this field and select Yes or No.
    2. SBR Designation (*): Does your project have a Small Business Reserve (SBR) designation? Click this field and select Yes or No.
      NOTE:
       Effective 8/29/2025, vendors that were certified Small Business Reserve (SBR) in eMMA have become Certified Small Businesses (CSBs). CSB vendors are eligible to participate in SBR designated solicitations. Please ensure that any documentation associated with this procurement correctly reflects the change in terminology.
      1. If SBR Designation is set to No, an additional mandatory Small Business Preference (*) field will appear. If Small Business Preference is set to Yes, you will be required to select at least one CSB vendor on the Vendor tab of the solicitation.
    3. VSBR Designation: Is your project part of the Veteran-owned Small Business Reserve (VSBR) program?
    4. Project Estimate: If you have an estimate of your project cost, enter it in this field.
    5. Project Cost Class: Click this field and select a cost class for your project.
    6. MBE Goal? (*): Does your project have a Minority-Owned Business Enterprise (MBE) goal? Click this field and select Yes or No.
      1. If you select Yes, two more fields display.
        1. MBE Participation (%): Enter the percentage for your MBE goal in this field.

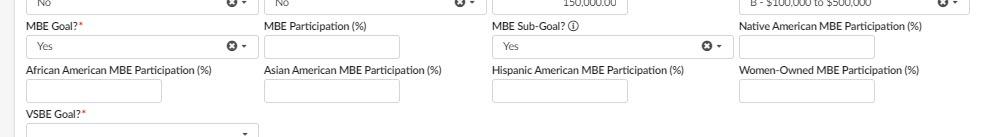

        2. MBE Sub-Goal?: Does your project have MBE sub-goals? Click this field and select Yes or No.
          1. If you selected Yes, five new fields display. Enter the appropriate percentages in the respective fields as they apply to your project:The MBE Sub-goal fields.Native American MBE Participation (%)African American MBE Participation (%)Asian American MBE Participation (%)
            Hispanic American MBE Participation (%)
            Women-owned MBE Participation (%)
    7. Green (*): Is this a green project? Click this field and select Yes or No.
    8. VSBE Goal? (*): Does your project have a Veteran-Owned Small Business Enterprise (VSBE) goal? Click this field and select Yes or No.
      1. If you select Yes, one more field displays.
        VSBE Percentage (%); Enter the percentage for your VSBE goal in this field.
    9. Grant Funding? (*): Does your project have grant funding? Click this field and select Yes or No.
      1. If you select Yes, one more field displays.
        Grant Funding Amount ($) (*): Enter the dollar amount for your grant funding.

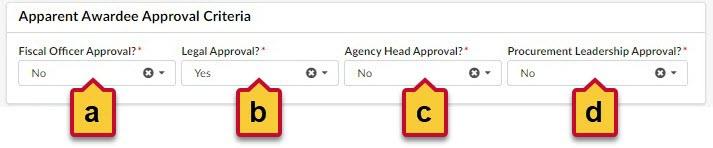

  1. Enter information in the Apparent Awardee Approver Criteria section. A red asterisk (*) indicates a required field. The diagram below shows required fields described in more detail below. (Note that this section will not appear when selecting the Public Notice or Small Procurement (e.g., Cat 1) Project Types) A diagram of the Apparent Awardee Approval Criteria.
    1. Fiscal Officer Approval? (*): Does your project need approval by a Fiscal Officer? Click this field and select Yes or No.
    2. Legal Approval? (*): Does your project need Legal approval? Click this field and select Yes or No.
    3. Agency Head Approval? (*): Does your project need Agency Head approval? Click this field and select Yes or No.
    4. Procurement Leadership Approval? (*): Does your project need Procurement Leader approval? Click this field and select Yes or No.

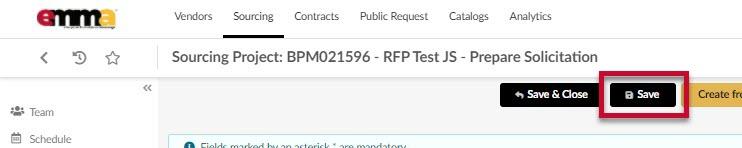

  2. Click the Save button at the top of the page.

Add Team Members (Optional)

This process continues from the last step in the previous process. It shows how to add Team members to your sourcing project.

Note: It is not mandatory to add additional users on the Team tab. However, only System Administrators and members of the sourcing project team will be able to see bids once they are unsealed. Also, only the team member given the Responsible role will have the ability to unseal the bids once the solicitation due date has passed.

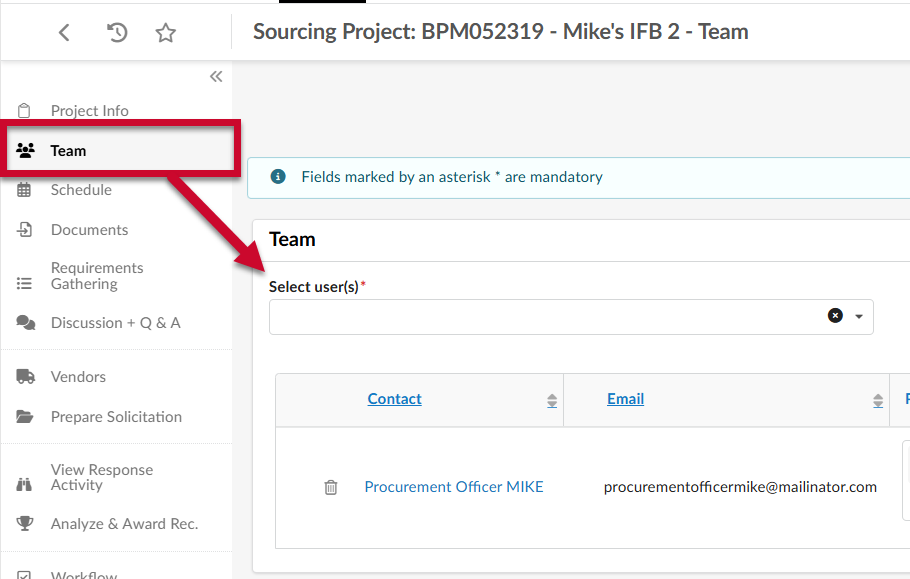

  1. Click the Teams tab on the left-hand side-panel. Click Select user(s) to open the drop-down menu, which displays a partial list of users in eMMA. Click one or more names on the list or click See All at the bottom of the menu to display the Browse Users window.
  2. In the Browse Users window, click the checkbox to the left of a team member you want to add. Repeat this step for each user on your Team and close the Browse Users window. The selected team members display on the Team page.

    NOTE: Team members can have more than one profile in eMMA. You can click on the team member’s name to view information about their eMMA profile.
  3. (Optional) To remove a user, click the Trashcan icon to the left of the user’s name.

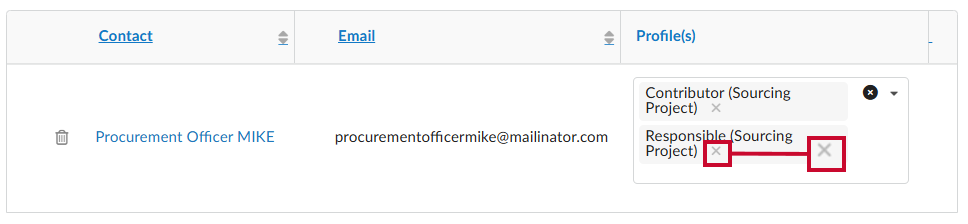

  4. Click the field to the right of a user’s email address, in the Profile(s) column, to open a drop-down menu.
  5. Select a profile role for the user from the drop-down menu. By default, each user is assigned a role. Added users are assigned the SME (Sourcing Project) role, while the Procurement Officer is designated the Responsible (Sourcing Project) role by default. Profile roles and permissions are further defined below.

    NOTE: You can assign multiple roles but only one Responsible profile role for the Team.Profile roles are defined as:
    1. Responsible (Sourcing Project):
      1. This role is by default assigned to the Procurement Officer but you can change it.
      2. This is the Owner of the Sourcing Project.
      3. They have read, view, and edit access to the project.
      4. All Vendor communications come to the person with this role.
      5. You can only assign one user the Responsible role per project. However, you must have at least one Responsible role assigned.
    2. Contributor (Sourcing Project):
      1. They have view access to the project and response activity.
      2. They can edit information on the Project Information, Team, Schedule, and Documents tabs
    3. SME (Sourcing Project):
      1. The Subject Matter Expert (SME) and default role assigned when you add a team member.
      2. This member can be assigned tasks in eMMA.
      3. They can receive email notifications (Forum messages).
      4. They can respond to Requirements Gathering questions or Evaluate/Score when assigned the task.
  6. (Optional) To remove a user’s profile role, click the X to the right of the role in the respective field in the Profile(s) column.

    NOTE: If you remove the user’s only role, it resets to the SME (Sourcing Project) role by default.
  7. When you’ve completed adding your team members and assigning profiles, click the Save button at the top of the page.

    NOTE: You must remember to click the Save button. If you don’t, you will lose your progress on this tab.

Create a Sourcing Project Schedule (Optional)

This process is optional, however your organization may require it in your solicitation. Please check with your supervisor. This process continues from the last step in the previous process. It shows how to create a schedule for your sourcing project. You can view the pre-populated schedule for the sourcing project and/or add and modify tasks and schedule items.  You can also assign tasks to Team members, if you have added them in the Teams tab. (Note that sourcing project schedules are only available for the following Project Types: IFB: Invitation for Bid (LP); RFP: Double Envelope Proposal (LP); RFP: Triple Envelope Proposal (LP); Small Procurement (e.g., Cat 2 & 3); Secondary Competition)

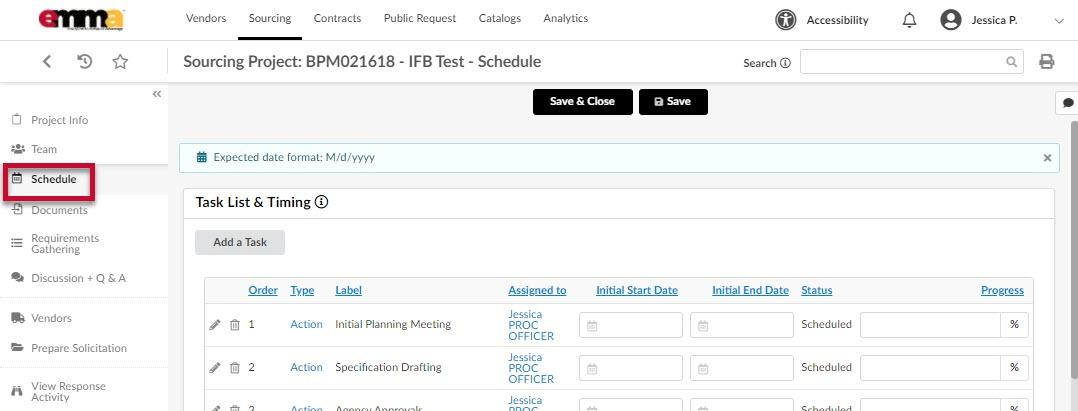

  1. Click the Schedule tab in the left-hand side-panel to display the Schedule page. For Requests for Proposals (RFPs) Double and Triple Envelope, you will need to create your own schedule tasks due to the complexity of RFP development and issuance.
    The Schedule tab for a solicitation.
  2. Steps 16-21 include instructions to create a new task for your schedule. If you do not need to do this, skip to Step 22.
  3. (Optional) Click the Edit (pencil) icon to the left of a task you want to change.

  4. (Optional) Click the Delete (trashcan) icon to the left of a task you want to delete.
  5. (Optional) Click the Add a Task button at the top of the Schedule page. The Edit Task window opens. You may need to scroll horizontally to see all the sections.

    NOTE: Once you create a new task and save it, the task moves to the end of the list.

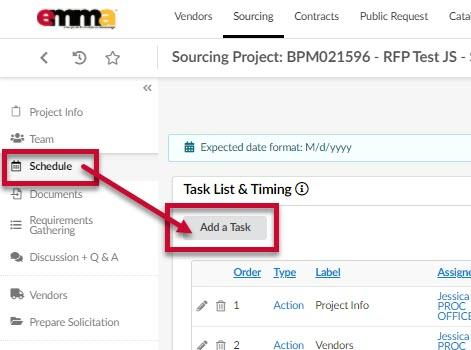

    The Schedule tab and the Add a Task button.
  6. Enter information in the fields of the Information section. A red asterisk (*) indicates a required field.
    A diagram of the fields in the Information section of the Edit task window.
    1. Task Label (*): Enter a label for your new task in this field.
    2. Type (*):Click this field to select a type for this task.
      1. Action (the default type)
      2. E-Mail Sent
      3. Event/Workshop
      4. Mail Sent
      5. Phase
      6. Phone Contact
      7. Meeting
    1. Task Code (*): This field lets you select the order sequence for a single task. Click this field and enter the letter “T” and a number for the row in which you want the task to appear. For example, you want the Specification Drafting task to be the 5th task on the list. You would enter “T5” in this field.
    2. Description: Enter a brief description for the task.
    3. Status: Click this field to select a status for this task.
      1. Scheduled (the default status)
      2. Not Started
      3. In progress
      4. Complete
      5. Close
    4. Manager (*): This field auto-populates with your information. Click this field to open a drop-down menu and change it to another member of your team, if necessary.
    5. Assigned to: Click this field to open a drop-down menu and select a member of your team you want to assign this task to.
    6. Progress: Enter a numerical value to update the schedule as to how much of this task is complete.
    7. Estimated Workload: Enter the number of workdays you estimate to complete this task.
    8. Updated/Actual Workload: Enter the actual number of workdays it took to complete this task.
    9. Parent Task: Click this field to open a drop-down menu and select a parent task for this task.
    10. Sourcing Steps:Click this field to open a drop-down menu and select an option from the menu.
      1. Vendors
      2. Open General Envelope
      3. Reverse Auction
    11. Previous Task: Enter the last task to take place before your task.

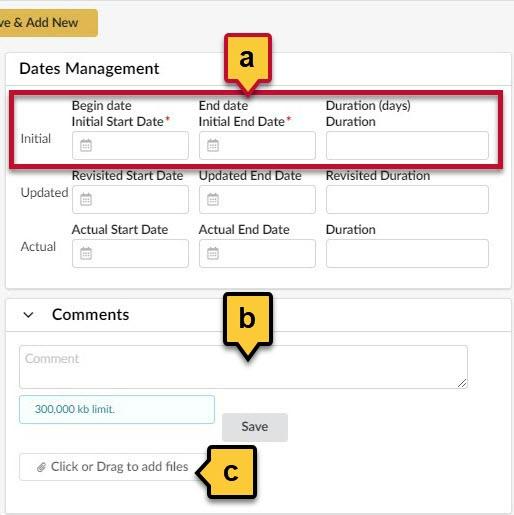

  1. Enter information in the fields for both the Dates Management and Comments sections. A red asterisk (*) indicates a required field.
    A diagram with the fields for Dates management.

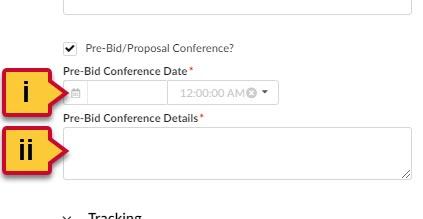

    1. Initial Dates (*): Click the Initial Start Date (*) field and select a date on which to start your task. Click the Initial End Date (*) field to select an end date. Enter a Duration (optional) period (in days) if desired.
    2. Comment: Enter comments in this field for your task.
    3. Click or Drag to add files: Click the Click or Drag to add files button to add a file from your device or drag a file to this button to add it.

      NOTE: Added uploaded files cannot exceed 300,000 KB.

      NOTE: You cannot edit documents directly in eMMA, but you can upload new files.

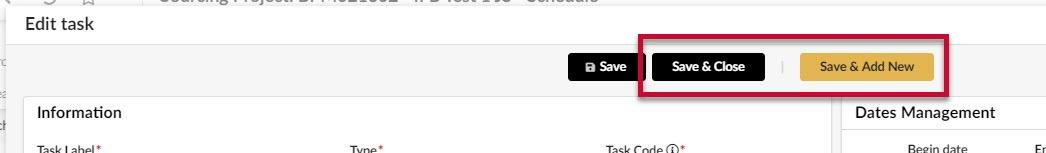

  1. Click the Save & Add New button at the top of the Edit task window and repeat Steps 16-21 until your schedule is complete. Click the Save & Close button when you are finished adding tasks.The Save & Add New button and the Save & Close button.
  2. Click the Save button at the top of the Schedule page to save your schedule. Scroll to the bottom of the Schedule page to view the Gantt chart of your schedule. Hover your cursor over one of the blocks to see a detailed pop-up about that block.

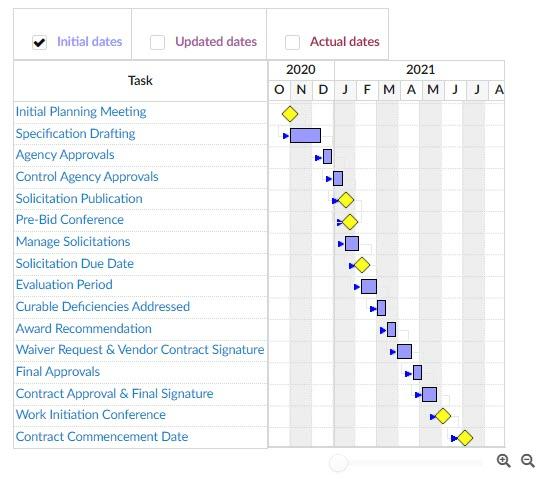

    A Gantt chart of a sourcing project.

Add Documents

This process continues from the last step in the previous process. It shows how to add documents to your sourcing project. (Note that the Documents tab will not appear when using the Public Notice Project Type)

NOTE: You can only add documents to sourcing projects of which you are the owner, and only your sourcing project Team members can view them. Vendors can view your documents if you grant them permission. Documents stored here can be copied to the solicitation and shared with Vendors later when you publish the solicitation, if desired.

NOTE: Documents added to the Documents tab will NOT be available to Vendors by default. In order to make documents added to the Documents tab available to vendors, they must be copied to the Attachments section of the Prepare Solicitation tab. For more information, please refer to Prepare Solicitation - Attachments later in this QRG.

NOTE: The uploaded document or file size must not exceed 300,000 KB.

NOTE: You cannot edit documents directly in eMMA, but you can upload new files.

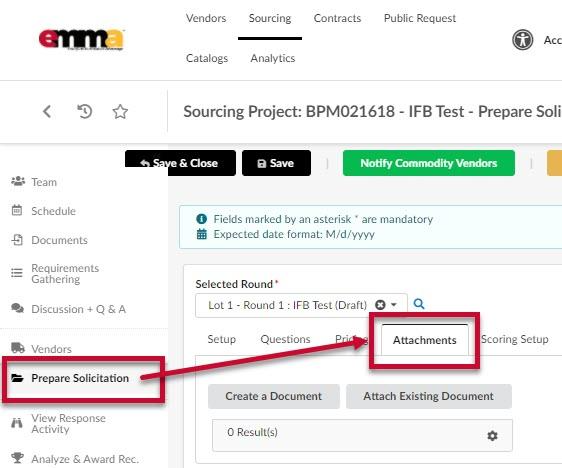

  1. Click the Documents tab in the left-hand side-panel to display the Documents page. Existing documents, if any, display in the Sourcing Project Documents pane.

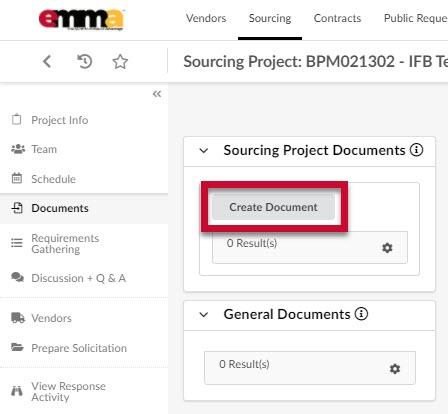

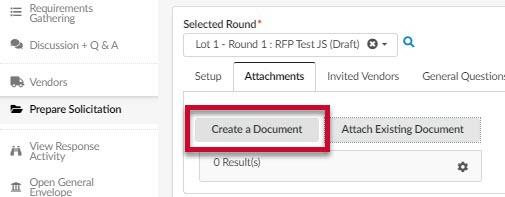

  2. Click the Create Document button in the Sourcing Project Documents pane. The Sourcing Project Documents pop-up window displays.

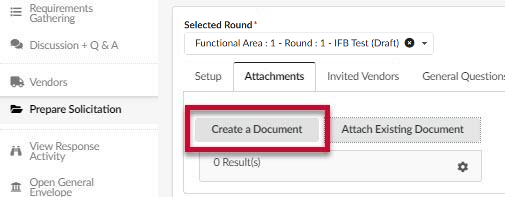

    The Create Document button.

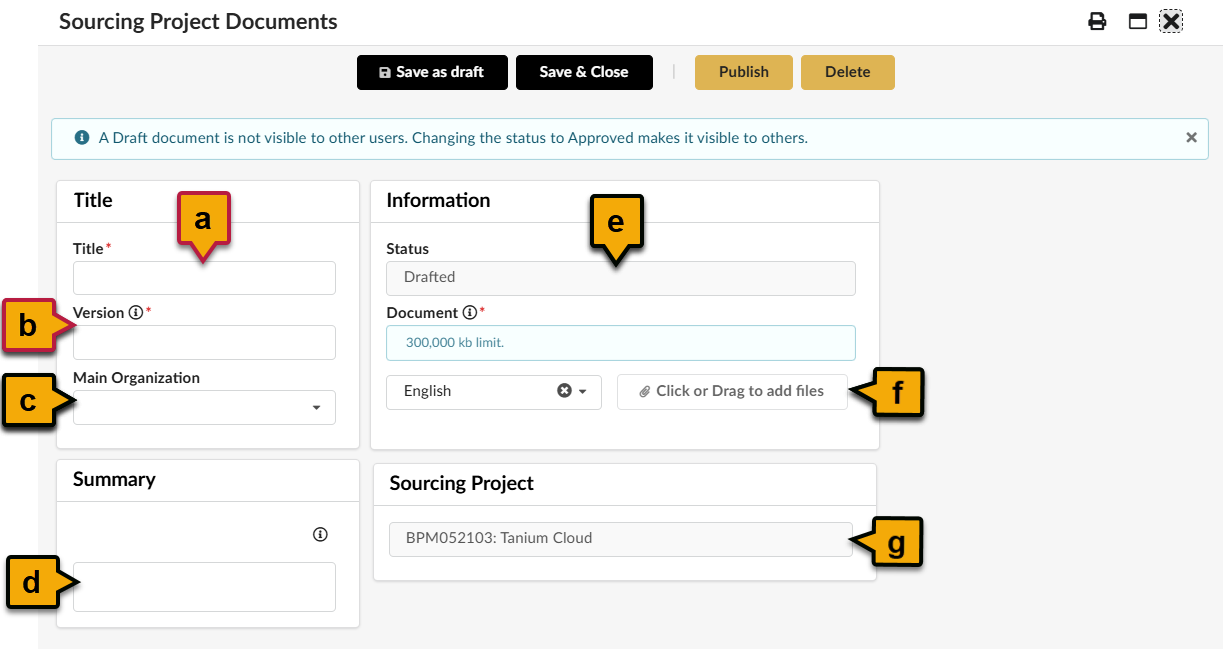

  3. Enter information in the form fields. A red asterisk (*) indicates a required field.
    1. Title (*): Enter a title for the document.
    2. Version (*): Enter a numeric value for the version of the document. The application will suggest the next version increment for each new revision.
    3. Main Organization: (Optional) To limit visibility of the document to users within a certain state organization, begin typing the name of the organization in this field, then select it from the drop-down menu when it appears. You may choose multiple organizations.
    4. Summary: (Optional) Enter a brief summary of the document. Once you click this field, text editing options appear above it.
    5. Status: This field indicates the current status of the document. You don’t need to do anything here.
    6. Click or Drag to add files (*): Click this button to choose a file from your device or drag and drop the file on this spot to add it.  The added file displays below this button. Click the X to the left of the document to remove it.

      NOTE: The uploaded document or file size must not exceed 300,000 KB.

      NOTE: You cannot edit documents directly in eMMA, but you can upload new files.

    7. Sourcing Project: This field indicates the sourcing project associated with this document. No further action is required here.

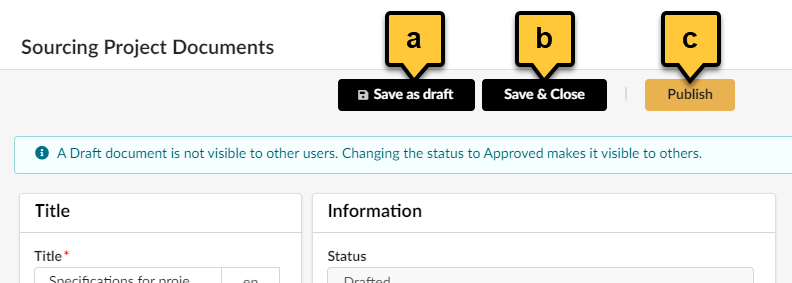

  4. You have three options to move forward:
    The Save as draft, Save & Close, and Publish buttons.
    1. Save as draft: Click this button to save the document as a draft. The Sourcing Project Documents window now shows the document listed (in the Information pane), tracking info of the document (at the bottom), and a Delete button (at the top) to remove the draft.

      NOTE: Other users cannot see documents in Draft status. Changing the Status to Approved makes it visible to others (see Step 26c). The image below shows a document in Draft status in eMMA. An orange background displays behind the title of the document in Draft Status.

      A document in draft status in eMMA.
    2. Save & Close: Click this button to save the document as it is shown and close the Sourcing Project Documents window.
    3. Publish: Click this button to publish or “Approve” the document and make it visible to others. The Sourcing Project Documents window now shows the document status as “Approved,” a New Draft button to create a new draft of the document (at the top), a Delete button to remove the document (at the top), and tracking information (at the bottom).

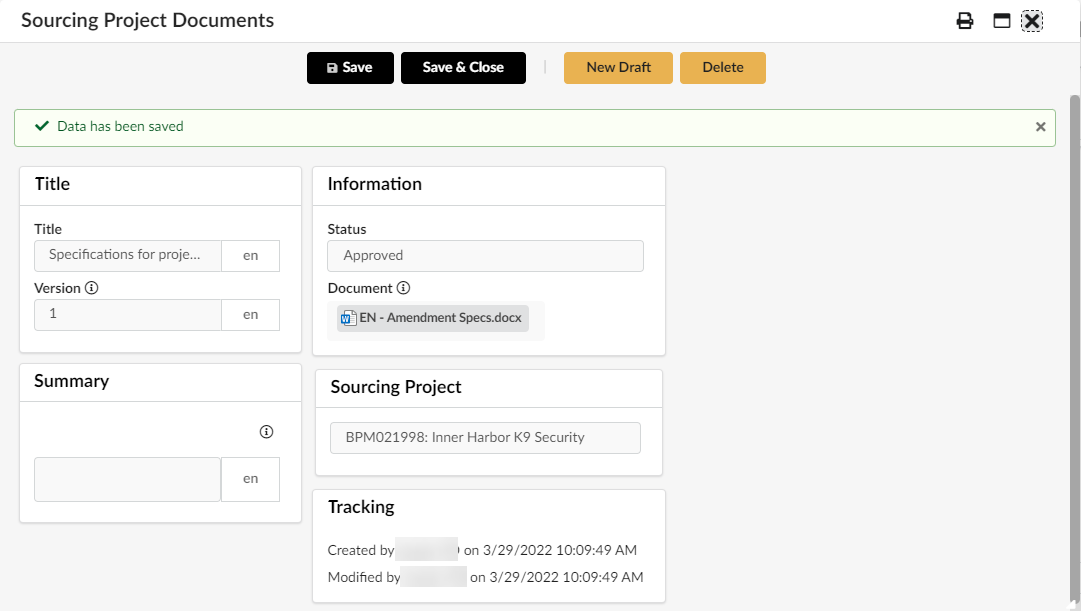

      The Sourcing Project Documents window with the New Draft and Delete buttons.
  5. Unless you chose option b (Save & Close) click the Save & Close button at the top of the window.

  6. Click the Save button at the top of the Documents page. Your document is listed on the Documents page along with version info, who created the document, the creation date, and the date last modified. Remember to click the Save button after making any updates or changes to your document.

    Click the Edit (pencil) icon to the left of the document Title to edit the document (upload a new version).

    NOTE: Once you add a document, you cannot edit a document directly in eMMA, but you can upload new versions.

    Click the Trashcan icon to the left of the document Title to delete the document. An exploded view of the trashcan and pencil icons. .

Select Vendors

This process continues from the last step in the previous process. It shows how to add vendors to your sourcing project based on identified criteria and requirements.

NOTE: For solicitations requiring a longer period, the list of vendors receiving notifications may need to be updated/refreshed to capture newly registered vendors for a specific category code.

  1. Click the Vendors tab in the left-hand side-panel.
    The Vendors tab.
  2. Click the Select Vendors button in the Consulted Vendors section. The Browse Vendors pop-up window opens and displays a list of Vendors based on the sourcing project’s main commodity.
  3. (Optional) If you have a specific Vendor in mind that may not be on the commodity list but can provide the required service, enter their name in the Keywords field, delete the Commodity Code from the Commodity field and click the Search button.
    1. Select the checkbox to the left of the Vendor and close the Browse Vendors window. That Vendor displays on the Vendors page.
    2. Click the ellipsis (three dots) icon to continue to Step 34.
  4. Click the Commodity field to open a drop-down list and click the See All option at the bottom. This list lets you add more commodities that are relevant to your sourcing project to get a broader selection of vendors. You can add as many commodities as you want in this field.

    NOTE: It is a best practice to select as many commodities as possible to obtain a thorough vendor list.

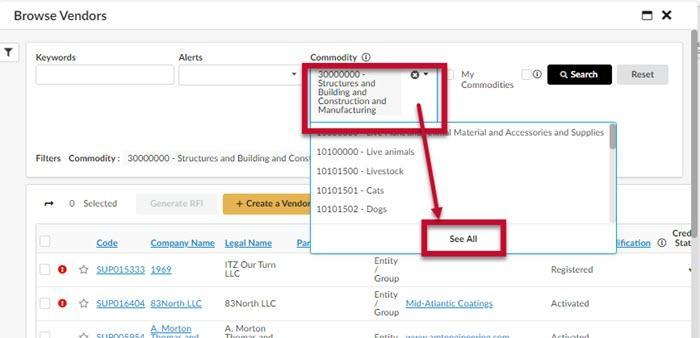

    The Commodity field and the See All option.
  5. The Select Commodities window opens with a full list of commodities. Use the plus A plus icon in a white box. and minus A minus icon in a black box. icons to the left of the commodity groups to expand and collapse them. Select the checkboxes to the left of the commodity(ies) you want to add and close the window. NOTE: Selecting a commodity level next to a plus icon or minus icon only provides vendors that are registered for that exact commodity, and NOT any sub commodities below that level.

    The selected commodities display in the Filters section of the window, below the search fields and above the list of vendors.

    A selected commodity in the See All window.
  6. Click the Search button at the top of the Browse Vendors window. A list of Vendors displays relevant to the commodities you selected.
    The Search button.
  7. Select the topmost checkbox to the left of the column headers to select all vendors on that page in the commodity.
    The Select All Checkbox.
  8. Scroll down to the bottom of the Vendors list and click the next page in succession. A list of unselected Vendors displays.
    The numbers of pages.
  9. Repeat Steps 37 and 38 until the Vendors on all pages are selected.
  10. Close the Browse Vendors window. The Vendors are listed in the Consulted Vendors section.
  11. Click the Save button at the top of the page.

    IMPORTANT: You must make sure you click the Save button or you will lose your progress to this point.

Prepare Solicitations - Setup

This process continues from the last step in the previous process. It shows how to set up your solicitation for your sourcing project. (Note: The Prepare Solicitation tab will not appear for the Emergency Sourcing Project Type. For Emergency Sourcing Projects, please go directly to Step 8 of the Award a Solicitation to a Vendor QRG.)

  1. Click the Prepare Solicitation tab on the left-hand side-panel. The Setup subtab displays a form.
  2. Enter information in the fields on the left side of the form. A red asterisk (*) indicates a required field.

    NOTE: Depending on your selections in the fields, more fields may display.
    A diagram of the fields in the Prepare Solicitation page.
    1. The Status, Round #, and Functional Area # fields are system generated. You do not need to do anything in these fields.
      • Note: After saving the solicitation information, a field for Functional Area Name will appear and must be completed.

    2. Solicitation Title (*): The title of your solicitation auto-populates here.
    3. Template (checkbox): Select this checkbox if you want to make a template from this solicitation to use in the future.
    4. Solicitation Type (*):Click this field and select the appropriate type of solicitation from the drop-down menu that opens. The Project Type selected when creating the Sourcing Project will determine the available options for the Solicitation Type field. Refer to the list below for the available options.
      • IFB: Invitation for Bid (LP): IFB: Invitation for Bid; IFB: Invitation for Bid (w/ Min Quals)
      • RFP: Double Envelope Proposal (LP): RFP: Double Envelope Proposal
      • RFP: Triple Envelope proposal (LP): RFP: Triple Envelope Proposal
      • Small Procurement (e.g., Cat 1): Quick Quote
      • Small Procurement (e.g., Cat 2 & 3):  Request for Information & Pricing; Request for Information; Request for Quote; Advanced Request for Proposal
      • Public Notice: Public Notice
      • Secondary Competition: PORFP; RFR - CATS Specific; TORFP
    5. Summary: Enter a brief introduction and summary for your solicitation.
    6. Additional Information & Instructions: Enter any additional information and instructions in this field.
    7. Alternate Link: Enter the link to the bid board on which this solicitation is posted, if applicable, i.e. BidExpress.
    8. Pre-Bid/Proposal Conference? (checkbox): Click this checkbox if you intend to have a Pre-Bid/Proposal conference for this solicitation. If you selected this checkbox, new mandatory fields display.
      NOTE: The Pre-Bid/Proposal Conference? checkbox will not appear until after the first time that you click Save.
      The fields for Pre-Bid Conference information.
      1. Pre-Bid Conference Date (*): Click this field and select the date of your pre-bid conference.
      2. Pre-Bid Conference Details (*): Enter the details of your pre-bid conference, like when, where, how to register, what Vendors need, etc.

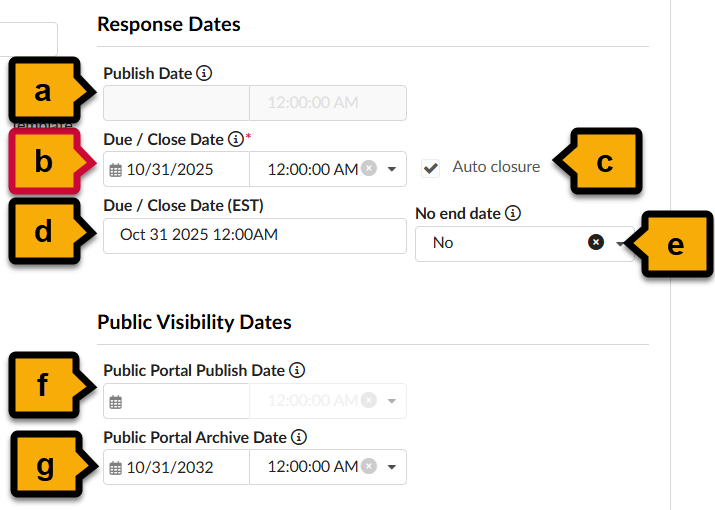

  3. Enter information in the fields for the Response Dates and Public Visibility sections on the right side of the form. A red asterisk (*) indicates a required field.
    1. Publish Date: This field auto-populates when you post the solicitation, later in these instructions.
    2. Auto opening (checkbox): Select this checkbox ONLY if you selected a future date for your publish date.  If selected, your bid period will publish automatically on the date you chose.
    3. Due/Close Date (*): Click this field and select the date that vendors can no longer submit responses.
    4. Auto closure (checkbox): The option to close the solicitation on the due date is selected by default and cannot be changed. You do not need to do anything here.
    5. Due/Close Date (EST): This field populates after you click Save. You do not need to do anything here.
    6. No end date: Do you prefer to have an open-end date? Click this field and select Yes from the drop-down menu. No is the default selection.
    7. Public Portal Publish Date: Click this field and select the date that you want to publish your solicitation in the public portal. Leave this field blank if you want to publish immediately.
    8. Public Portal Archive Date: Click this field and select the date that you want to unpublish your solicitation in the public portal.
  4. Click the arrow to the left of the Advanced options section below the Response Dates and Public Visibility.

    NOTE: Some checkboxes are selected by default and some cannot be changed because of the nature of your project type.

  5. Review and make selections necessary to your project.  Options include: Solicitation Visible to Public, Sealed Responses, Vendors must Acknowledge & Identify intent to Respond, and Bid Holders List Visible to Public.

    If the option for Bid Holders List Visible to Public is not selected, then click the checkbox to the left of it to select it.
    The Advanced options sections.
  6. Click the Save button at the top of the Prepare Solicitation page.
    The Save button.

Prepare Solicitation - Pricing

This process continues from the last step in the previous process. It shows how to set pricing for your solicitation.

  1. Click the Pricing subtab in the Prepare Solicitation page.

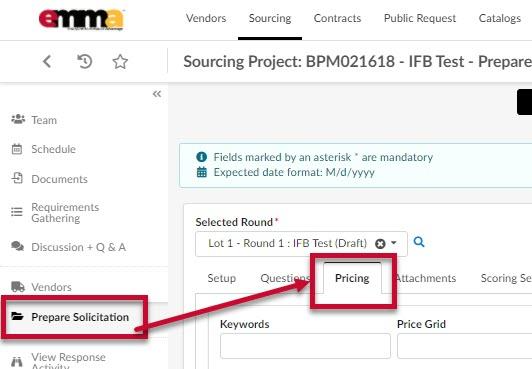

    The Prepared Solicitation tab and the Pricing subtab.
  2. Enter information in the form fields to create a line item within the pricing grid for each item for bid. A red asterisk (*) indicates a required field. A (V) to the right of the heading indicates values that are visible by vendors and the public, if you opted to make this a public solicitation.

    NOTE: The following diagrams are broken into halves for easier viewing; left, and right. The top image is an overview and shows the entire pricing grid.

    An empty Pricing grid in the Pricing subtab.The left half of the pricing grid. The right diagram of fields in the pricing grid.
    1. Item Code (V) (*): This item code auto-populates. You do not need to do anything here.
    2. Item Type (V) (*): Required item is the default selection in this field, but there are additional options in this drop-down menu, if needed.
      1. Required Item (if this option is selected, Bidders cannot submit their bids until the unit price for the line item is entered)
      2. Price Adjustment
      3. Optional Item
      4. Additional Fees

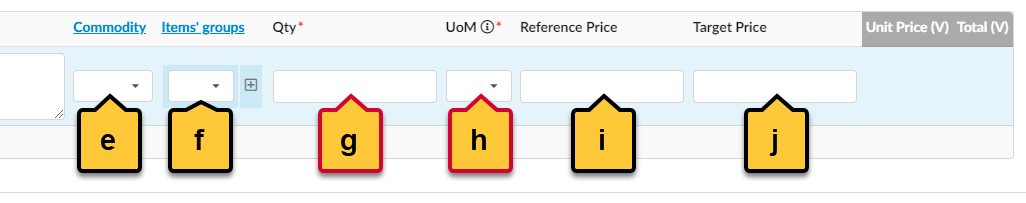

    1. Item Label (V) (*): Enter in the name and brand of the item in this field.
    2. Detailed Description: Enter a detailed description of your item in this field.
    3. Commodity: Click this field and click the See All option at the bottom of the menu. The Select Commodities window opens. Enter a term for your commodity in the Keyword field and click the Search button for relevant results. You may need to click the plus A plus sign in a white box. and minus A minus sign in a black box. icons to expand and collapse commodity tiers. Click the checkbox to the left of the commodity that applies to your item and close the Select Commodities window.
    4. Items’ groups: Leave this field blank. Some functionalities of eMMA are not in place yet.
    5. Quantity (*): Enter the quantity needed for your item in this field.
    6. UoM (*): Click this field to open the drop-down menu and select a unit of measure for your item. (Optional) Click the See All option at the bottom of the menu to select from a more detailed list.
    7. Reference Price: Enter the price of the item for one unit on the market. This is the market value or previous value of that line item from other contracts.
    8. Target Price: Enter the amount you calculate the item should cost.
  1. Click the Save button at the top of the Prepare Solicitation page. A new line is created in the pricing subtab and displays at the top of the list. Your first item is entered and displays below the empty line-item fields in the Pricing subtab.Two line items; one complete and one new one.
  2. (Optional) Repeat Steps 49 and 50 to add new items, if necessary.

Prepare Solicitation - Attachments

This process continues from the last step in the previous process. It shows how to attach documents to your solicitation.

IMPORTANT!! If the solicitation is being conducted by DGS and the Issuing Agency/Sub-Agency/Site field is set to DGS or associated sub-agency or division during solicitation setup, eMMA will automatically include the Electronic Transaction Fee Acknowledgement and Remittance Requirement document in the Attachments subtab. DO NOT DELETE OR REMOVE THIS DOCUMENT.

  1. Click the Attachments subtab in the Prepare Solicitations page.

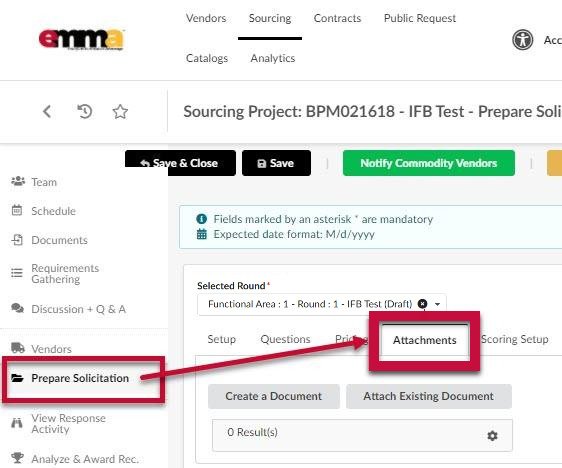

    The Prepare Solicitation tab and the Attachments subtab.
  2. (Optional) Click the Create a Document button to add a new document to your solicitation.

    NOTE: Uploaded documents cannot exceed 300,000 KB.
    The Create a Document button.
    1. In the Content Editor window that opens, click the link that best describes your document.
      Document types in the Content Editor field.
    2. Enter information in the document window fields and add the document (Click or Drag to add files button).

      NOTE: Make sure you change the document status to Approved so that both team members and vendors can view it.
      The Approved option for an attachment.
    3. Click the Save & Close button at the top of the window. Your added document displays below the Attachment subtab.
  3. (Optional) Click the Attach Existing Document button to add a document that exists in the Documents tab of your project. The Sourcing Project/Documents window opens and lists any documents you added to the Documents tab.

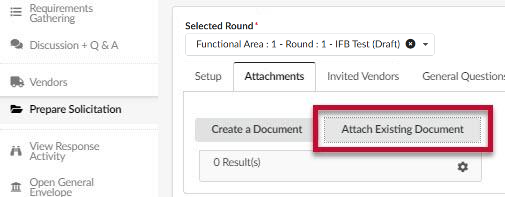

    The Attach Existing Document button.
    1. Select one or more checkbox(es) to the left of the document(s) you want to attach and click the Save & Close button at the top of the Sourcing Project/Documents window. The selected document(s) display in a list on the Attachments subtab.

      A checkbox for an attachment and the Save & Close button.
      NOTE: You may need to go back and approve documents. Documents in Draft status will not be visible to vendors. The Type column for your document will be orange and read “Technical Documents (Drafted)”.
      A Document in Draft state.
  4. Click the Save button at the top of the Prepare Solicitation page.

    Manage PRG Goals

    This process continues from the last step in the previous process. It shows how to manage PRG Goals on a solicitation.

    Notes:
    • Not all solicitations will have PRG Goals. Some sourcing projects are created after a PRG intake request has been fully approved.

    • PRG goals can also be added to sourcing projects that are not linked to a PRG intake request. See Step 58 for instructions on manually adding a PRG goal from within the sourcing project.

    • PRG requests can be created after a sourcing project is created and linked to the solicitation before it is published. For more information on how to create and submit a PRG request, refer to Create and Submit a PRG Request in eMMA (Initial Release).

    • If a solicitation has multiple functional areas, it may have multiple PRG requests associated with it. The goals on each request will only appear within the sourcing project once the request is approved. All requests need to be reviewed prior to releasing the solicitation.

  5. Navigate to Subcontractor Utilization Goals tab of the sourcing project.
  6. Review the PRG goals.
    1. If the sourcing project is linked to an approved PRG intake request, the goals will pre-populate in the MBE & VSBE Utilization Goals section with a status of "Approved". The goals cannot be edited; however, they can be deleted. To delete, click the Trashcan icon and click "Yes" to confirm deletion.
  7. For sourcing projects that are not linked to a PRG intake request or to add additional goals to a sourcing project that is linked to a PRG intake request, click +Manually Add Utilization Goals and complete the fields.
    The Send button.
    1. Program: The relevant diversity program (e.g. "MBE")
    2. Diversity Subcategory: The applicable subcategory for the program (e.g. African American under the MBE program).
    3. Utilization Goal %*: This is the final percentage of the total estimated amount that must be allocated towards this line item or diversity category.
    4. Supporting Factors (check all that apply): The influencing factors when making the determination for the final utilization goal.
    5. Explanation for selected utilization goal*: A thorough justification for the final utilization goal.

      Click Save. Click Submit.

      Each goal will undergo an individual approval workflow. Note: Goals must be in "Approved" status prior to releasing the solicitation in order for Vendors to be able to see and provide information on subcontractors for that goal.

      Notify Vendors and Publish Solicitation

      This process continues from the last step in the previous process. It shows how to notify vendors of your solicitation.

  8. Click the Send button at the top of the Prepare Solicitation page. A new window opens with your selected vendors.
    The Send button.
    • Click the Send and close button at the top of the Solicitation window. This notifies the vendors you selected in the Vendor tab. Two prompts display. Click OK for both.
      The Send and close button.
    • Click the X in the corner of the Solicitation window to close it.
    • Prior to notifying commodity vendors, you must wait 2 minutes after hitting the Send button. This prevents Vendors from receiving duplicate communications if they are listed in the solicitation as a Vendor and are categorized as a commodity vendor.

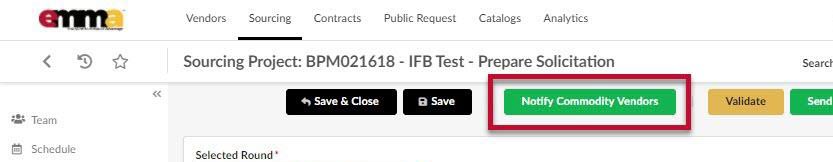

      Click the Notify Commodity Vendors button at the top of the Prepare Solicitation page. This sends a notice to all vendors with this solicitation’s specific commodity codes listed in their profiles. A prompt displays. Click OK.The Notify Commodity Vendors button.

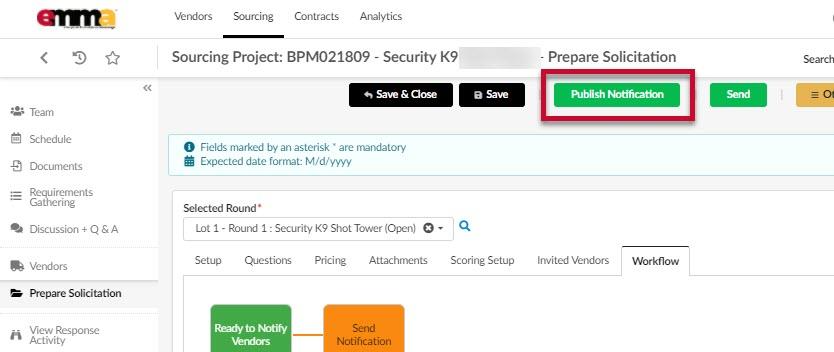

    • Click the Publish Notification button at the top of the Prepare Solicitation page. A prompt displays. Click OK.
      The Publish Notification button.
    • The Workflow subtab in the Prepare Solicitation tab shows that your message has been sent to your vendors.

NOTE: To see a complete list of the invited Vendors after posting the solicitation, navigate to the Invited Vendors sub-tab on the Prepare Solicitation tab.

A list of invited Vendors is displayed. To view the names of the specific contacts that were notified at a Vendor, hover your mouse over the number next to the Vendor's name in the Notified Supplier's Contact column.

Next Steps

Wait for responses and the due date. Then see the Buyer QRG Analyze Vendor Responses in eMMA .
